The Indelicate (and comforting) Sounds of Progress

August 24, 2019 by clove Leave a Comment

It feels good to be moving again. Interactive is hustling to get as close to completion as possible before the end of October, when we have to be out of our rental.

Unfortunately, the stop work delay has led to a crew shortage that we are doing our best to alleviate through Matt’s efficient contributions, and sub-contracting out a couple of tasks that Interactive would normally do themselves.

We’ve been focused on making quick decisions on final orders for things like flooring, tile, lighting, exterior siding, appliances, and millwork. It all has to be ordered now.

We continue to face hurdles with the City. The fact that we have a unique “duplex plus suite” zoning has caused all manner of headache, since this arrangement does not currently exist in the eyes of the building code. Duplex? No problem! Single family + secondary suite? No problem! Duplex + secondary suite? Um…

At the last electrical inspection, the inspector said we needed 4 hydro meters for the property: one for each unit (including the secondary suite which can only ever be a rental given our zoning), plus a separate meter for any shared services between the two suites. Huh? The City ultimately deferred to BC Hydro, citing an obscure memo that seemed to suggest that having multiple meters was one possible avenue, but did not say we couldn’t have less (we’re planning for two, one for each strata unit). I called BC Hydro and spoke with someone who thankfully offered to write an email confirming that from their perspective, we could install 1 or 50 meters – it was entirely up to us who pays for the electricity.

The City has also decided that from a fire and life safety perspective, we have a triplex on our hands. Cue noncombustible siding and extensive fire separations between main and secondary suites. The BC Building Code has put out a revision for public comment that specifically addresses duplexes + suites, but who knows how long that will take to move through the various stages of approval. Certainly won’t happen before the end of October. So we find ourselves only pushing back when a requirement is clearly ludicrous, and sucking up the rest in the interest of forward movement.

With each successive visit to the project over the past few weeks, I feel a little bit more excited and a little less afraid that the project will fail. I am allowing myself to believe that this is all going to come together in the end and we will achieve what we set out to – albeit down a much more circuitous road than we had expected. I am allowing myself to imagine ourselves living in our new space and unpacking our things without having to keep all the boxes. I’m fantasizing about what we’ll do with all our free time. Month-long trips exploring northern Canada and upper Vancouver Island! Haida Gwaii! New York City! Belgium for cyclocross! Gardening! Writing! Ah, dare to dream…

And now for some photos!

Here’s what’s been happening outside:

Exterior clip installation continues
Behold Matt’s precise clip alignment
We had to add a whole bunch of these metal straps for seismic restraint between the two units
Then patch over the straps with membrane to restore the integrity of the air barrier
Sealing of exterior penetrations
Starting on the exterior insulation (6″ of Roxul Cavityrock)
Base of wall bug screen + insulation
Insulation install
Future location of electric vehicle charging station!
A start on what will be double strapping (vertical then horizontal) to attach cladding and create the drainage/ventilation gap

Moving inside…

Framing!
Roughing in electrical…
…plumbing and ventilation distribution
Zehnder’s new ComfoFlex woven fibreglass air distribution tubing
All tubes begin or end at the Heat Recovery Ventilator’s closet. HRV to come.
Insulation downstairs
Insulation upstairs. R-14 on the underside of the roof – the rest goes outside
And then drywall!
More drywall!
This is all starting to look very house-like

Filed Under: Construction, Featured Tagged With: Passive House construction

It’s Unanimous (Again)

June 28, 2019 by clove 4 Comments

We got through public hearing #2. Phewf.

I had considered not presenting at all this time around (it is optional). Surely this was a no-brainer, right? Surely it’s in everyone’s best interest to approve our new Development Permit and just finish the project?

But then I watched the Committee of the Whole video (this is the meeting at which Council hears staff’s report and votes on whether to put the project forward for public hearing). They all voted in favour of proceeding, but one councilor was very critical of the design and suggested that it was only approved because of the existing house and with that constraint removed, the whole design could have been reconsidered (not in any practical way, but that’s another matter).

This was his perspective, but the sentiment at the first public hearing was extremely positive and it wasn’t just because we were re-using the existing house. Nevertheless, I realized that once again we had to do everything we could to ensure a positive outcome, especially since so many of the current councilors are new. I invited neighbours to write letters and a couple came out in support (thank you Gail and Len!). And I prepared another presentation in spite of my intense fatigue over the whole process.

After my presentation, the same councilor reiterated his negative opinion about the design and concluded by saying he hoped this sort of thing never happened again. Thankfully, the other councilors spoke more supportively and ultimately they all voted in favour.

So we’re back in business. I’ve mentally shifted gears back to critical path decision making. We also got notice that we will likely have to be out of our rental place by the end of October, so we are pushing hard for completion in 4 months – not impossible, but a challenge to be sure!

Here’s where we’re at:

roof bump-out framing in progress
Matt’s installed all of the clips that will secure the cladding to the framing (with 6″ Roxul Cavityrock insulation between)
back of house
back of house

Filed Under: Construction, Featured, Rezoning Tagged With: community engagement, Passive House construction

Making Lemonade (and Cabinets)

May 17, 2019 by clove Leave a Comment

I am convinced that one must be a dogged optimist to be a developer, as the actual completion of a project is simply the cumulative result of having solved innumerable problems along the way. If one stops believing that each new problem has a solution, the project dies.

And so it is with this spirit that we have made the most of our time waiting (and waiting…) for our new Development Permit. Here are a couple of big items we’ve been working on:

Interior Design

We hired an interior designer (welcome to the team, Lisa Dunsmuir of Step One Design!). We’d originally designed around the existing interior walls of our house because we were going to keep them. With that constraint gone, Lisa did a major redo that we think is a big improvement. She still had plenty of constraints to work with, mind you, given that all the windows, doors and ground level plumbing connections were already installed.

The biggest change to our half was to create a more distinct “front of house” (kitchen, living, entry) and “back of house” (bedrooms, bath) on the upper floor:

She also reworked our “mom suite” layout to be more functional:

On the other half, the biggest change was to rejig the upper floor to add an ensuite bath for the master bedroom (which we’re told people like):

We are now in the process of finalizing all finishes (carpet, tile, flooring, toilets, sinks, lighting etc). This has taken a surprising amount of time and now that we’ve gotten through most of it, I am grateful that we won’t be making these choices on the fly and trying to visualize how it will all work together on our own. The number of options in any one finish category is mind-boggling, and having Lisa funnel us into a just a few good ones has been incredibly valuable. Once we do get back to work on site, Lisa’s spec book and detailed drawings will allow the crew and contractors to move a lot faster.

Cabinets

Matt is now a cabinet maker! He’d allocated a chunk of his time over the winter and spring to work on our project. Since we can’t work on the actual house, we figured we could get a jump on interior finishes by making all of the mill work for our half. Working off Lisa’s drawings, Matt’s making the cabinet boxes out of plywood and will finish the drawer/door fronts and cabinet ends with processed fir from our old house. I think it will look beautiful. Here are some images of the process:

plywood cabinet boxes
Matt’s garage workshop at our interim rental house
true 2×4 from our old house
Matt runs the 2x4s through the table saw to cut them down to 1″ thickness and expose the straight grain, and then glues them together to make a 12″ wide panel
He then runs the panel through the surface planer to a 3/4″ thickness
Here he has glued two 12″ panels together to create a wider panel
sample of a completed (unfinished) panel
panels for side of lower cabinets and fridge cabinet

Filed Under: Construction, Design, Featured Tagged With: cabinet construction, Passive House construction

Stuck in a Kafka Novel

April 19, 2019 by clove 8 Comments

Help, we’re stuck in a Kafka novel!

Kafkaesque:
: of, relating to, or suggestive of Franz Kafka or his writings especially : having a nightmarishly complex, bizarre, or illogical quality // Kafkaesque bureaucratic delays
…the word Kafkaesque is often applied to bizarre and impersonal administrative situations where the individual feels powerless to understand or control what is happening.

(Merriam-Webster)

As described here, we chose to change the roof shape of the ‘existing’ half of the duplex to a gable roof. This change required that we go through a Delegated Development Permit process.

A Delegated Development Permit (DDP) allows staff to review and approve “minor” changes to a Development Permit, which is a more streamlined process than applying for a completely new DP. We evaluated the timeline, cost and benefits and chose to go ahead, submitting the application in October. The first round of comments from staff were supportive of the roof change, but (of course) pointed out a few other minor items that would require a resubmission.

After we resubmitted in November (and were well into framing construction), the code inspector assigned to our project flagged the fact that we referred to existing structure in the Building Permit drawings but that there appeared to be no existing structure. We explained to the city planner that the design was the same, except that we had replaced existing with new framing (read the rationale here). Development Permits are intended to govern form and character, and this change had no impact on either. As such, it hadn’t occurred to us to talk with the planning department prior to dis-assembling. Apparently we were mistaken.

This revelation kicked us out of the DDP process. City staff said they were not comfortable approving this ‘major‘ change without council input and therefore instructed us that we needed to apply for a new Development Permit before we can continue work. Queue stop work order.

Surely this is not the first time that the late discovery of structural deficiencies has led to a change in approach, and surely applying for an entirely new development permit is not the only path? They said if we’d come to them before we dis-assembled the existing framing, they would have been able to work something out. Like what, keep a wall so we can still call it “existing”? The DP application form says to expect a 3-6 month process. How is that in any way reasonable for a project that is mid-construction?

Upon hearing this judgement, I did what any analytical person would do: I poured over the Local Government Act and Land Use Procedures Bylaw to understand the policy that was informing staff’s direction. I discovered two important things:

  • “Minor” and “Major” are not defined anywhere, so it’s up to someone’s subjective interpretation of what is a minor versus a major change. In our opinion, a change that can be documented by revising a couple of notes in the drawing package is a minor change – particularly when it has zero impact on form and character.
  • the Local Government Act provides a mechanism to appeal a planning department’s decision to deny a DDP application. The appeal process would mean that we could directly address Council and ask them to either uphold or overrule staff’s decision.

So when city staff rejected our DDP application, citing that they were uncomfortable proceeding without Council’s input, we invoked our right to appeal. Our sole interest was to resolve any concerns quickly so that we could continue with construction. A 3-6 month wait could be lethal to our small project.

A few days after notifying staff of our appeal, we received a letter from the city solicitor’s office saying that we could not in fact appeal. This is worth quoting:

You getting this? Neither are we. I guess that’s why they’re the lawyers and we’re not.

We’ve discussed this process at length with our planning consultant and we remain convinced that we have the policy backing to support our position and our right to appeal. How can staff’s direction be anything but a rejection of our application?

Unfortunately, our case is muddied by the perception that there is a lot of wanton demolition going on in our city by developers. The Acting Director of Planning said in our first meeting that just the week prior, they had a similar case come forward, and they seemed intent on following the same process for both, irrespective of the unique circumstances of each.

It became clear that City staff were not going to budge, despite many conversations and correspondence to address their stated concerns. Our last ditch attempt was to present directly to council at a public hearing (any citizen who submits the proper notice can address Council for up to 5 minutes). If staff were saying they weren’t comfortable moving forward without Council’s input, we would ask Council directly for their input.

I sent a letter to all councillors in advance of the public hearing to provide context and give them the best opportunity to consider our case and ideally, to pass a motion to allow staff to complete our DDP application. We had also exchanged several emails with the Mayor, who seemed willing to do what she could.

I gave my presentation, after which Mayor Helps thanked me and moved on to the next speaker with no further discussion.

We stuck around until the end of the meeting, and Ian (our planning consultant) had a discussion with the Acting Director and the city’s solicitor to better understand their rationale. We remain convinced that the solicitor’s advice is flawed, and listening to him speak left me with the impression that he just wants to be right. But to take up the matter further and engage our own legal advice would only mean more cost and time that we don’t have. We later learned that Mayor Helps had gone to staff earlier that day to ask if Council could in fact pass the motion we had requested, and was told that they could not. The Mayor seemed genuinely interested in helping our case, but was prevented from doing so by staff following the advice of their solicitor.

So we reluctantly raised the white flag (having lost nearly 2 months to the false hope that we could find another, faster resolution) and submitted a new Development Permit (complete with $3,000 application fee to review drawings that have already been reviewed). We are now well into Month 4 of the stop work order as we inch along the City’s review process, with an estimated delay-related cost of $30,000 so far.

Who does this serve? Why is the City not doing everything they possibly can to help projects that add housing and that are wholly consistent with both our climate action imperative and the City’s Official Community Plan? It’s counter-productive, non-collaborative, reactive, punitive, and mired in a procedure over which no one seems to have any control. I understand the need for policies and procedures, but when they’re just ticking boxes, there is a real cost (and a lost opportunity) that they either don’t appreciate or believe they are powerless to change.

The one voice of reason in all of this has been the manager of inspections, who allowed us to finish wrapping the house prior to enforcing the stop work order, so that the structure is protected from the elements. He has also since allowed us to complete the rest of the roof assembly to resolve some moisture and durability issues.

Stay tuned for a new public hearing. If you feel inclined, you are welcome to write a letter of support to mayorandcouncil@victoria.ca. And for those readers for whom this all sounds familiar, watch for the launch of our new city approvals survivors’ group!

Here are some photos of where we’ve left things. While we wait, we can all at least appreciate our beautifully colourful Cascadia fibreglass entry doors.

Thanks for reading!

Filed Under: Construction, Featured, Rezoning Tagged With: development permit, infill

It’s All About the People

January 20, 2019 by clove 2 Comments

This stuff doesn’t get built by robots or aliens. At least not on our project, and at least as far as we can tell.

Aliens or not, the crew at Interactive have been exemplary. I continue to be amazed by what they accomplish in any given week.

A few of the crew from Interactive, plus Matt! L-R: Matt, Josh, Pat, Mitch, Brittany. They’re not just smiling because the brownies I brought them were so delicious; these are beautiful people!
If a project manager was a super hero, he’d be like Mike!

Probably because this is the first time Matt and I have done this, I feel a special kind of amazement seeing the crew transform our two dimensional drawings into three dimensions on site.

We had the location survey done recently – this is when the survey company checks the location of the building and issues a certificate verifying that it’s where it’s supposed to be. Russ, owner of Interactive, said casually, “Looks like we once again managed to put the house where it goes.” He’s done this a lot. To me, it’s all still a bit magical.

In 2D
In 3D

Filed Under: Construction, Featured Tagged With: Passive House construction

Construction Progress

December 28, 2018 by clove Leave a Comment

The crew at Interactive continues to impress with their quick progress and adaptiveness in the face of driving rain and near gale force wind storms. As they broke for a well deserved holiday, here’s how far we’ve come.

Prepping the low slope side for its roof; sheathing in progress; roof trusses installed in the sloped roof half
Sheathing progresses
Window bucks partially installed; attempting to protect the openings from wind and rain to be ready for window delivery
Prepping the window rough openings with impermeable membrane at the sill
Prepping window openings
Interactive spent a couple of days preparing the window rough openings, then managed to get all of the windows and all but two of the doors placed in one day
Cascadia Universal series windows and doors, with very low-e Cardinal triple glazing
Here is the same progression, viewing from the front of the house
Installing Soprema Sopraseal Stick VP, our waterproofing and air barrier

Filed Under: Construction, Featured Tagged With: Passive House construction

Framing Progress

November 16, 2018 by clove 2 Comments

Framing has to be one of the most satisfying stages in a building’s construction. After feeling like we spent a dog’s age underground – not to mention the few years that came before we touched the merest speck of dirt – framing progress is fast and visible. We are now seeing plans on paper being rendered in three dimensions. Yeeha.

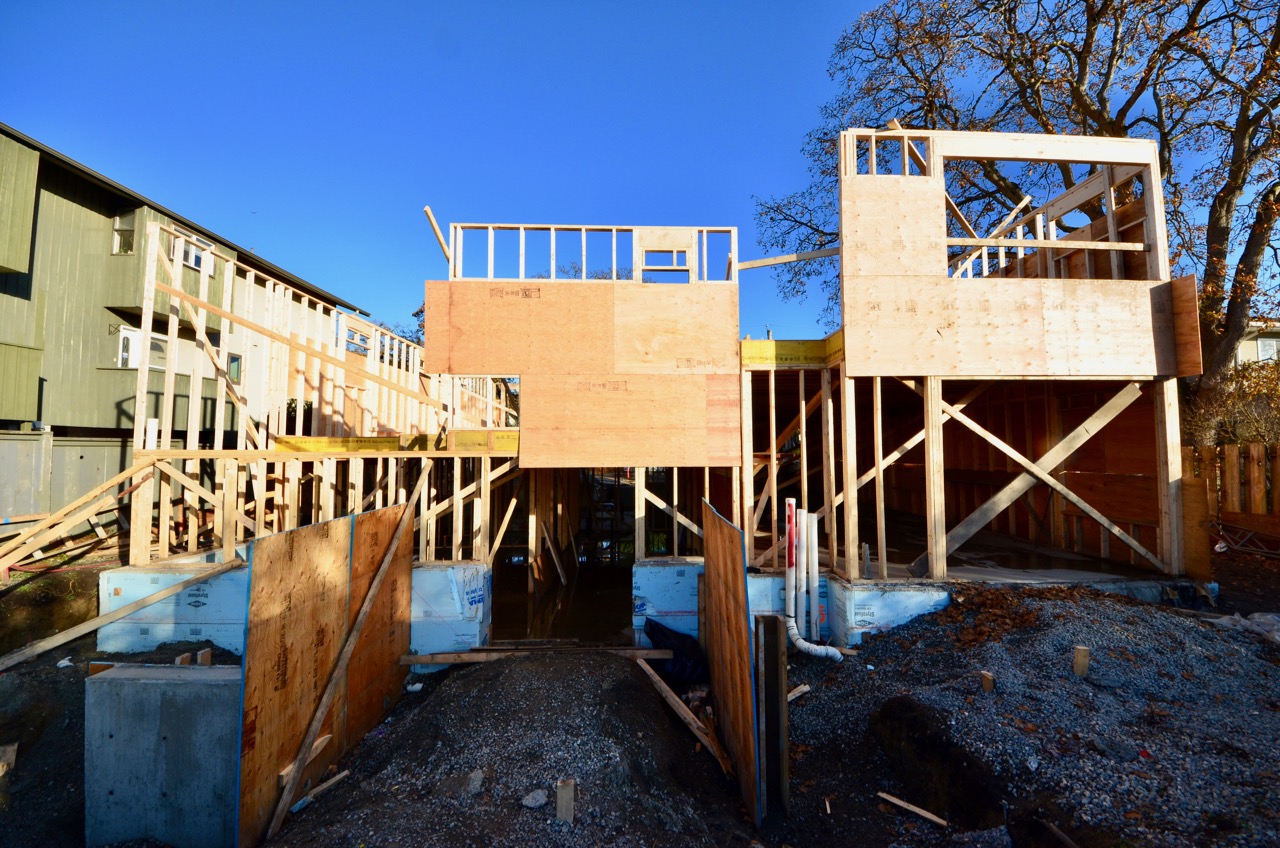

After getting this far a couple weeks ago:

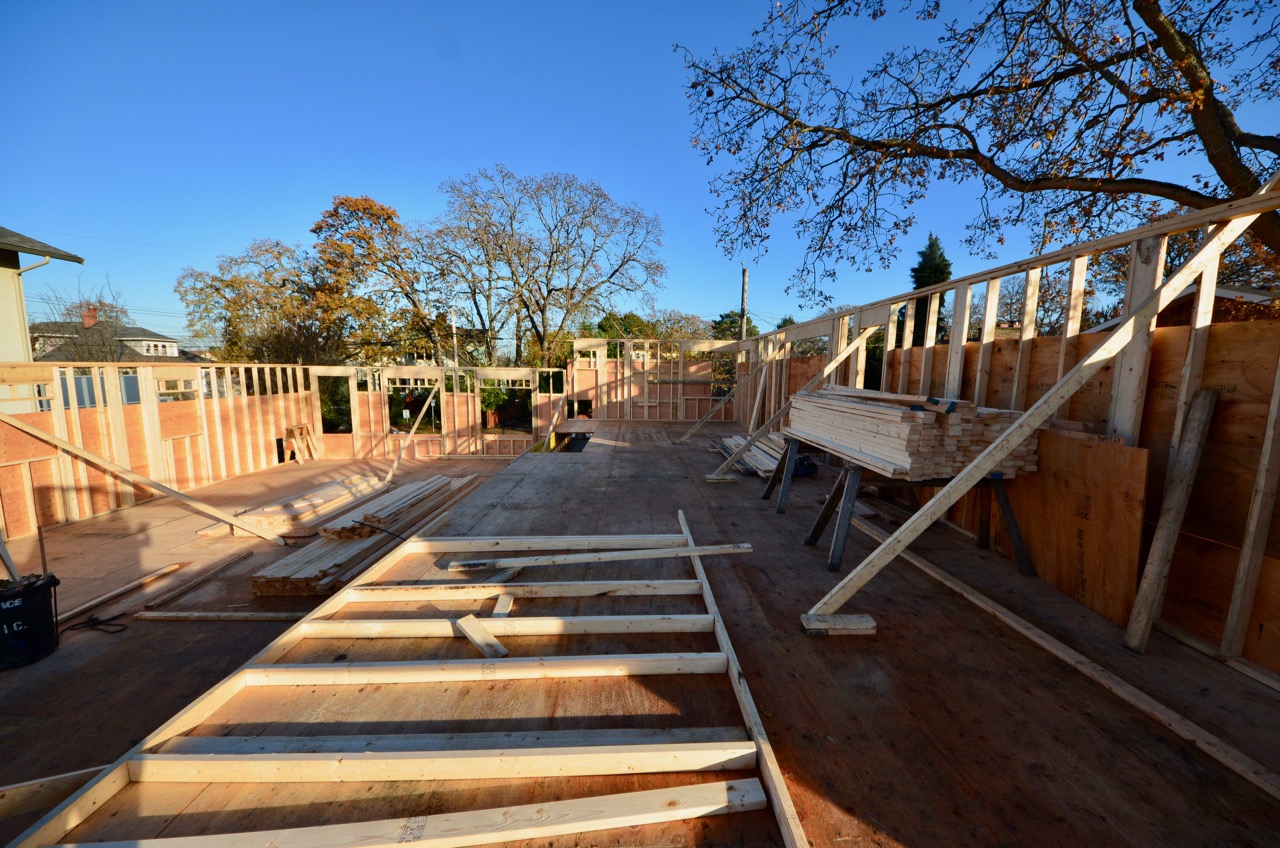

front view

back view

Last week’s highlight was taking the steps up to the second floor:

view from the top, looking east

Then there was the thrill of standing where our kitchen will be, and then looking out the window opening of our new bedroom:

view from the front, this week

view from the back

Filed Under: Construction, Featured Tagged With: Passive House construction

Master Class in Construction Sequencing

November 1, 2018 by clove 2 Comments

Things are really zipping along on-site, thanks to some ingenious sequencing work by our Project Manager, Mike.

Here is the progress update in photos and a video.

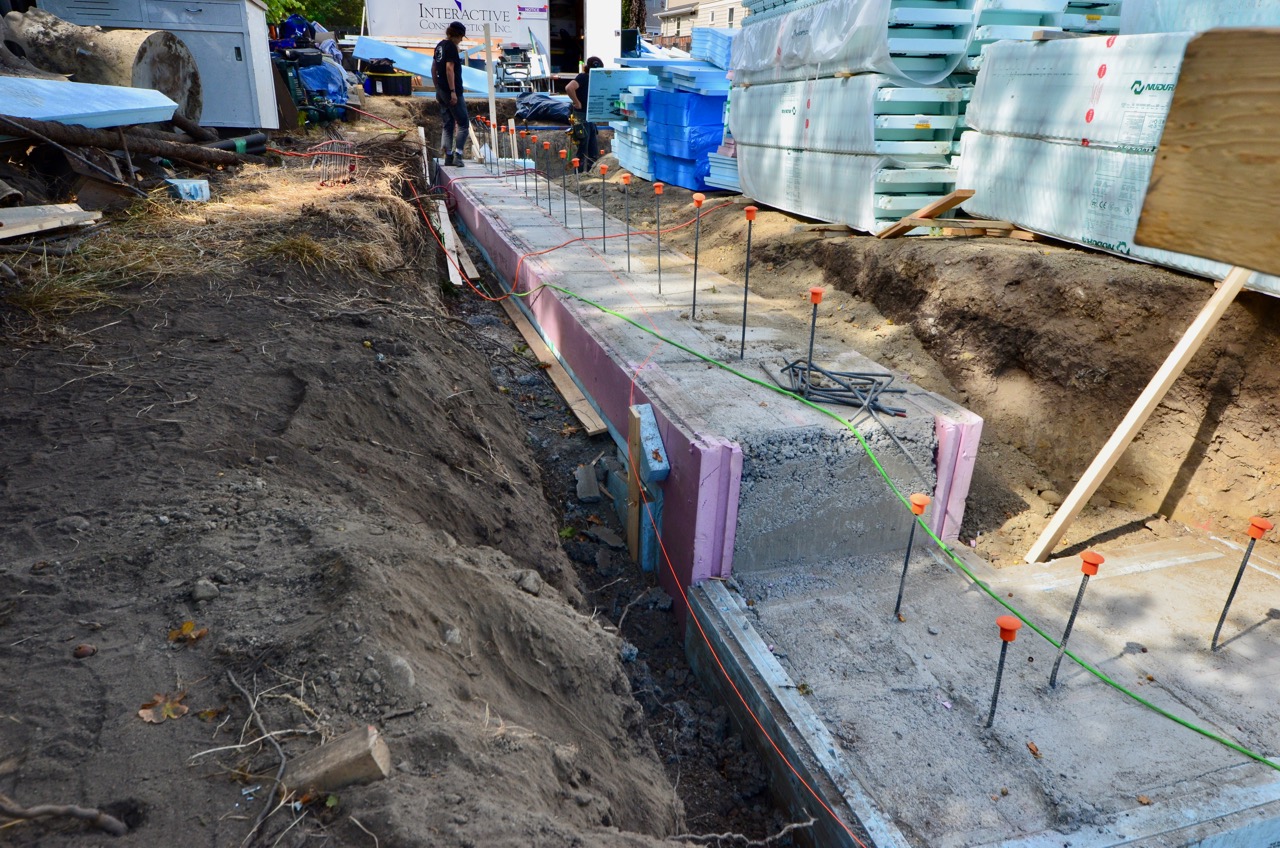

Insulated Concrete Form (ICF) foundation walls are wrapped with self-adhered waterproofing membrane. 4″ of additional rigid foam insulation is being installed on the outside of the ICFs for a total of just over 6″ insulation on the exterior side:

Here we can see the exterior rigid insulation on the foundation walls and 6″ of rigid insulation topping off (and surrounding) the footings:

View from the back yard:

Below grade plumbing is installed; gravel is laid and protected with poly in preparation for pouring the below slab spray foam:

Spray foam was applied on Monday and Tuesday of last week (in four “lifts”, or separate applications):

We added 6.75″ total for R-40 below slab. The product is Heatlok Soya, which claims a more environmentally friendly blowing agent than previous generation products. It’s very sensitive to weather during application and curing, but the weather gods shined their temperate, dry smiles on us this week.

Spot checking the total thickness:

Here’s a short video of the application process:



Tubing was then installed for the in-slab hydronic radiant heating system. This was Thursday:

Tubing spacing is ~12″ in most areas; tighter in the baths, and generally more widely spaced than in a non-Passive House due to the low heating load.

And by Friday we had a poured slab – two slabs, in fact; one for each side:

We kept it watered between weekend rain showers to encourage an even cure:

I think this means we can no longer call our project “the hole”. If we aren’t careful, pretty soon we’ll be calling it a house.



Filed Under: Construction, Featured Tagged With: construction, Passive House construction

Construction Progress

September 14, 2018 by clove 1 Comment

Construction Progress: a more harmonious pairing of words I have yet to encounter during our project!

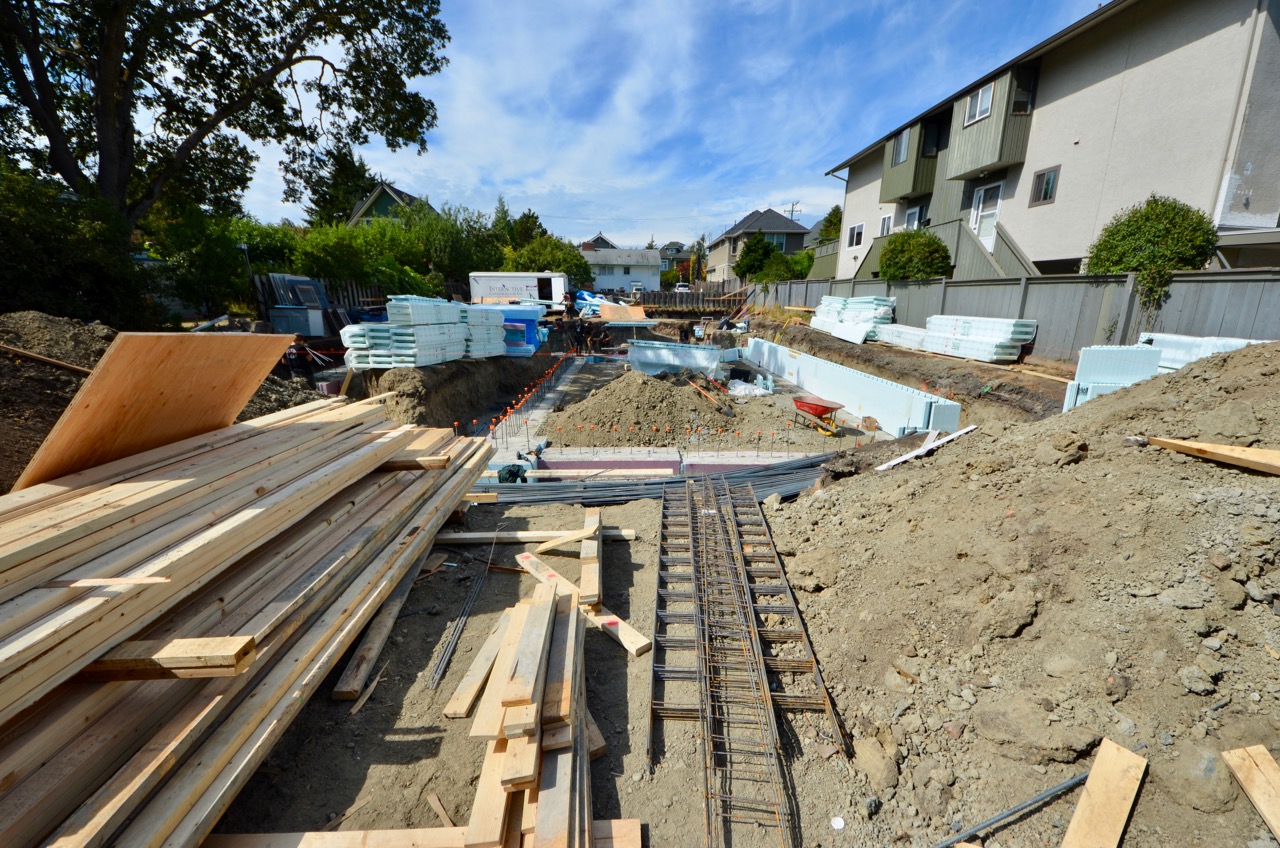

Here are some images from Interactive’s below-grade work over the last couple of weeks.

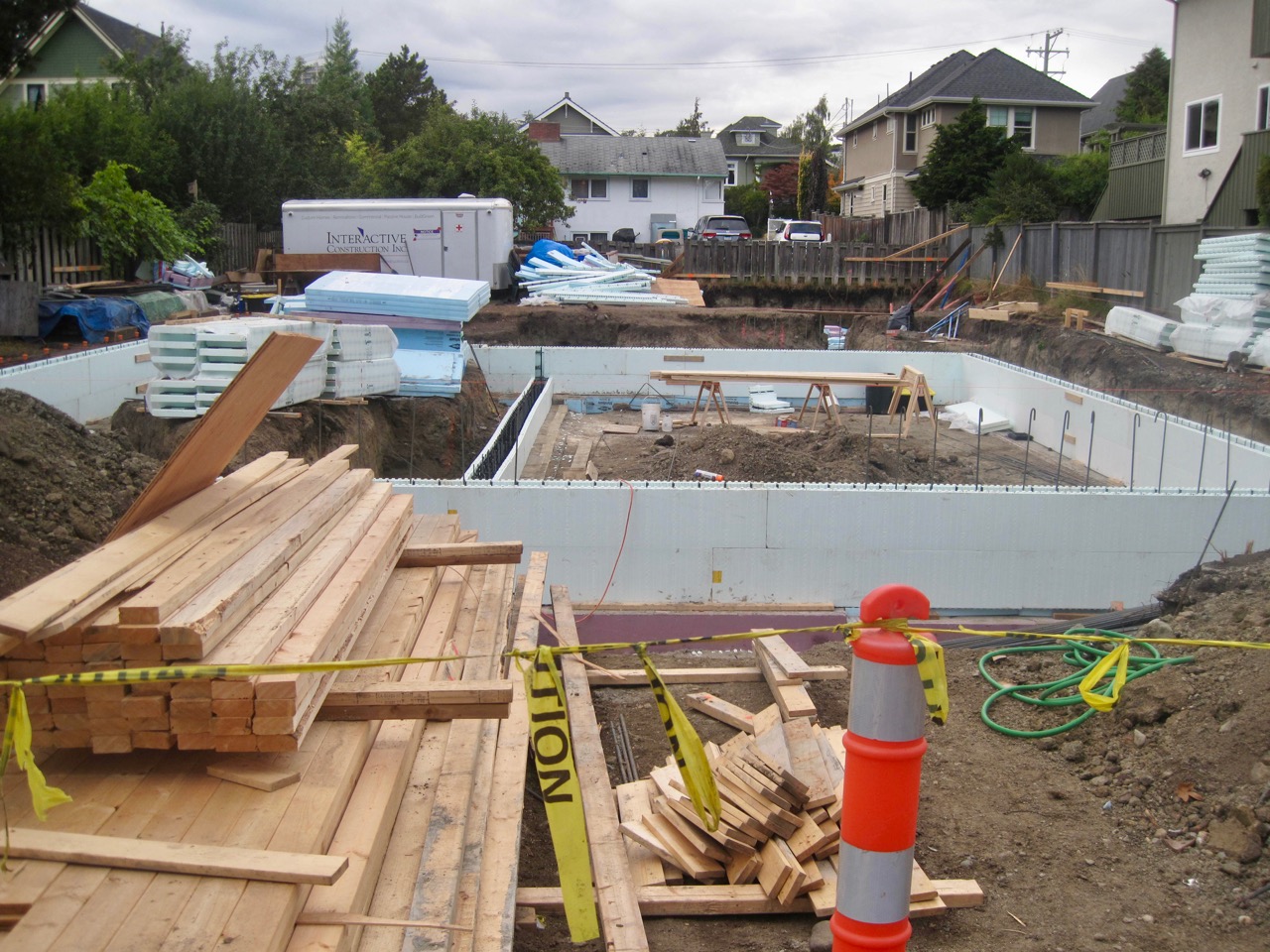

Footings are poured into a 6″ thick foam form and prepped for the Insulated Concrete Form (ICF) foundation walls

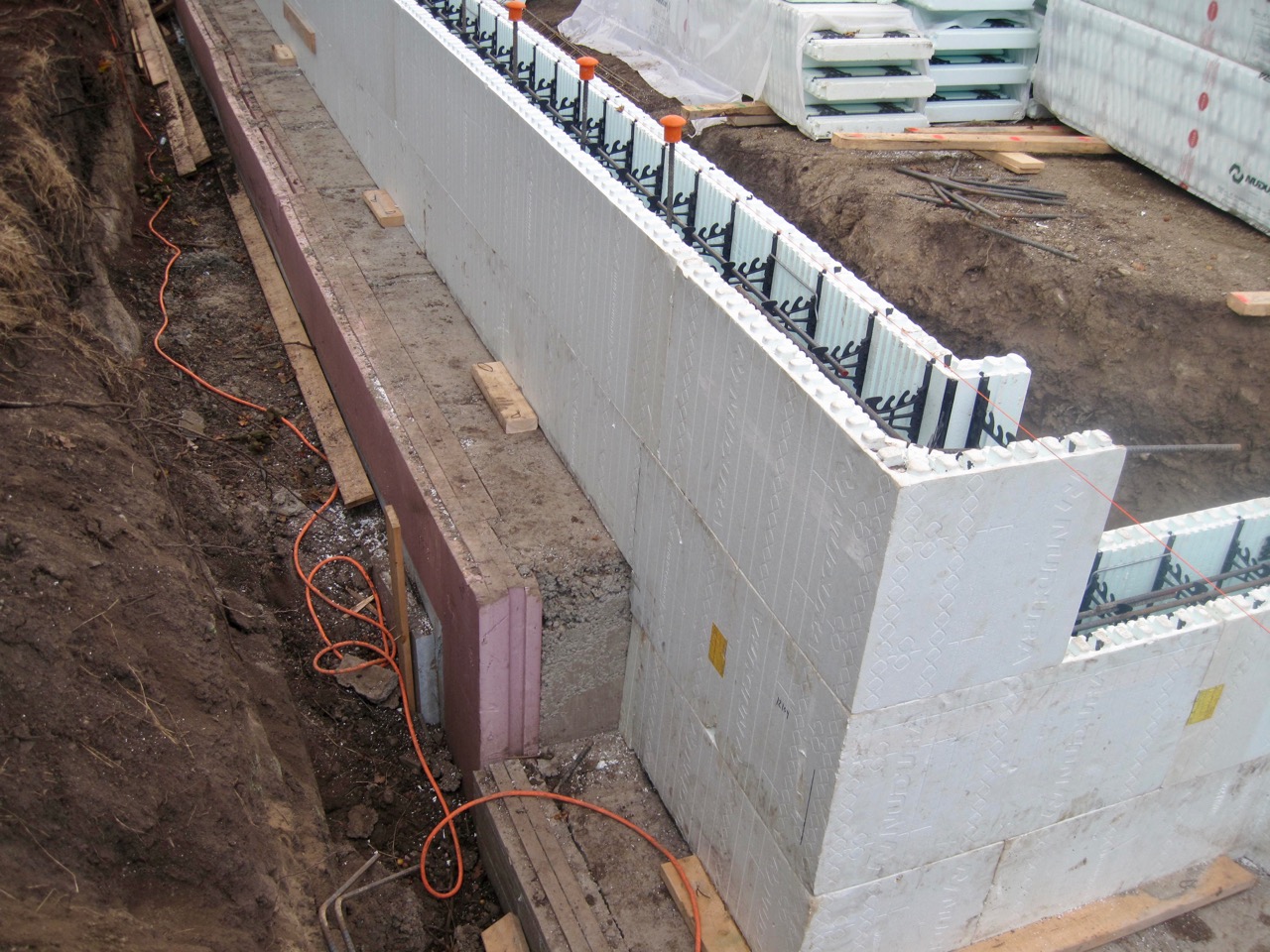

ICF forms going in

ICF forms going in

More ICF forms!

Fergus, after hours security cat

Filed Under: Construction, Featured Tagged With: Passive House construction

She’s Coming Down…and Woah, Progress!

August 24, 2018 by clove 2 Comments

After hearing from our structural engineer that we can’t keep our existing roof, and that we need to make significant modifications to the existing floor joists and structure to meet current seismic code; after being put on hold indefinitely by the company scheduled to do the house lift, and after considering other related complications, Matt and I made the difficult choice to disassemble what remains and reuse it for other purposes.

Not how we had imagined or hoped things would go, but given where we are, we are confident this is the most practical choice to keep the project moving and manage our costs. Learning has been a big part of this process, and we likely would have taken a few different turns along the way knowing what we know now.

A number of considerations tipped the balance:

  • The cost of the house lift and modifications to the existing structure is considerably more than building new. And that’s not accounting for all the weird little things that will crop up along the way when working with an existing building, like, say, the walls being crooked and not fitting on the new foundation and below grade walls. And there just isn’t much left to lift! We would be spending a lot of effort and cost to move around four walls and a floor.
  • Disassembly allows us to keep moving. With no lift/move required, the excavation company can come in with their bigger/faster/more available excavation equipment and start right away.
  • Disassembly allows us to use the beautiful old growth fir floor joists, planks, and framing for any number of visible features, like interior doors, cabinets, shading features, soffit, and other wood accents. Matt can also likely build his entire workshop using this material. If kept in place, the wood would have been 1) drastically modified by new structure and 2) covered in drywall.

In short, it was a move toward simplicity. Sometimes you have to make the most practical choice, emotions aside. And Matt and I are heartened by the fun possibilities in re-using the old wood in new ways. We intend to keep the same design, although we are considering the possibility of switching from the current hip roof on the ‘existing’ half to a gable roof, also for simplicity.

And…Progress!

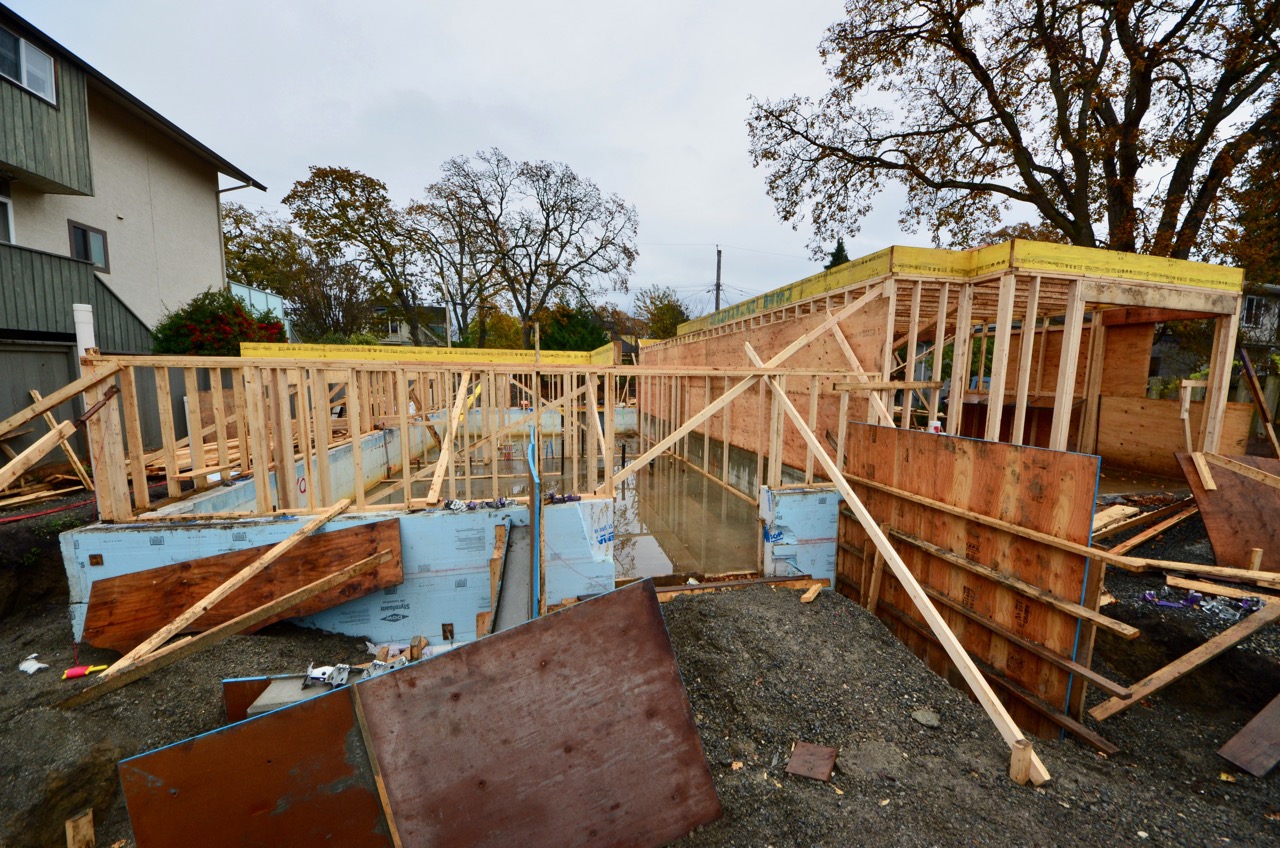

Wow, it’s amazing how quickly things can happen when you remove a barrier! This thing might get built yet.

Here was our house just before we made the call:

Then we had our meeting with Interactive and they got right to work, spending two days removing the roof and walls carefully enough to keep and stack the good wood, leaving us with just the basement:

And by the end of the week, we were down to this:

Then Level Lift came in with their machines to remove the rest and prepare the ground for the new foundation:

I have to say, progress feels good.

And in the spirit of Konmari, we wish to thank our old house for its service and acknowledge its time on the block and in our lives. We are grateful to have landed here and to have lived in this house before its transformation into something new.

Filed Under: Construction, Featured Tagged With: construction, passive house

  • « Previous Page
  • 1
  • 2
  • 3
  • Next Page »

Who is Stretch Developer?

Stretch Developer is written by Christy Love. In partnership with my husband Matt, we are challenging ourselves to create the kind of homes we want to live in and see more of in our community. Home is the incredible Victoria, BC, Canada.

Sign up!

Sign up to receive email notifications of new posts.

Recent Posts

  • New Uses for Old Wood Part 2 September 26, 2021
  • Ongoing Preparations for the Apocalypse August 13, 2021
  • Things We’ve Noticed – Energy Edition May 29, 2021
  • Passive House Suite for Rent April 17, 2021
  • Things We’ve Noticed – Comfort Edition March 14, 2021

Blogs We Like

Green Building Advisor Blogs

Musings of an Energy Nerd

Treehugger

Talk to ARYZE

Recent Posts

  • New Uses for Old Wood Part 2
  • Ongoing Preparations for the Apocalypse
  • Things We’ve Noticed – Energy Edition
  • Passive House Suite for Rent
  • Things We’ve Noticed – Comfort Edition
  • New Uses for Old Wood Part 1

Tags

budget building permit cabinet construction climate action climate change community engagement construction deep energy retrofit design design progress development permit duplex duplex + suite energy consumption energy efficient design financing financing passive house finding land food security home inspections infill low energy design neighbourhood engagement net zero passive house Passive House comfort Passive House construction Passive House construction costs passive house for sale Passive House performance Passive House performance; Sanden CO2 heat pump Passive House rental Passive House systems passive house testing performance pro forma property search tips reclaimed wood reclaimed wood construction rezoning roof row house small lot development small lot subdivision ultra low energy

Copyright © 2026 · Metro Pro Theme on Genesis Framework · WordPress · Log in



Loading Comments...
